FY 2025-26 Q2 - July to Sept
We inherited a broken system in July (negative cash flow, silent quality failures, zero infrastructure). Instead of scaling headcount, we rebuilt foundation: we isolated and stabilized the content engine, formalized Scope of Work, recorded training videos, established clear QA accountability and implemented micro-team structures for better coordination. I bought a MacBook M4 Pro that actually made a difference in how fast I could work.
When I came back from the hospital in early July, I had two crises on my hands.
One was my mother's recovery-she needed constant monitoring, timely medication, and emotional support. The other was the agency.
June left us in a bind. We'd completed 20 test projects for our enterprise client but hadn't been paid. My team was confused about how to use the content engine when it started throwing errors. Clients were finding Lorem Ipsum text and incorrect company names on live sites. And I had little cash in the bank.
This isn't a story about heroic hustle or grinding through the night (though there was plenty of that). It's a story about what happens when you realize that systems are literally how you survive when you can't personally carry everything.
And it matters because every founder scaling from 5 to 20 people hits this exact wall. The question is whether you rebuild the foundation or just keep stacking blocks on top of a broken one.
Part 1: Cashflow is King (And I Learned This the Hard Way)
Let me be specific about where we were:
- We'd completed 15 projects, but invoices hadn't been processed
- Cash reserves were exhausted. I'm not exaggerating—I'd used my personal funds to cover team payments because payroll comes every month
- More projects were coming in from the client (which was good), but we couldn't hire developers without cash (which was terrifying)
- Without additional developers, our delivery slowed
- Slower delivery delayed invoicing, which delayed cash, which stopped us from hiring
- Result: We were locked in a self-reinforcing loop: No cash → no hires → slower delivery → delayed payment → no cash.
This problem isn't unique to us. Any agency scaling on retainers or project-based work eventually hits this wall. The real constraint isn't demand or talent—it's payment timing and cash reserves.
I'd experienced this before when subcontracting through Schbang. I remember invoices remaining unpaid for over 120 days despite stated 60-day terms on DAIS & NMAJS enterprise clients. The work was delivered on time. But the cash got stuck in the agency layer, forcing contractors like me to absorb the financial strain more details here. It's an uncomfortable truth about agency cash flow: delays are often not about capability or performance. They're about who is forced to finance the system.
agencies are labor-first businesses.
You sell time, expertise, and execution. Your largest and least flexible cost is people. And payroll is due on fixed dates regardless of when clients pay.
"Cash flow is a hydrant; profit is a mirage."— Frank Bettger, How I Raised Myself from Failure to Success
We had profit locked in contracts. We didn't have cash sitting in a bank account. The distinction between those two things cost us a month of operating at minimum capacity and a month of constant stress.
The Three Decisions That Unstuck Us
Decision 1: Create Formal Scope of Work (SOW) Documents
Before: We'd get a client request and just... start building. The brief was vague. Boundaries weren't clear. Scope crept. Nobody really knew what "done" looked like.
After: We created detailed SOWs that spelled out:
- Max pages that needs to be built
- What content was the client's responsibility vs. ours
- How much content we should realistically generate
- What counted as out-of-scope
This reduced scope creep and made projects predictable.
Decision 2: Build Cash Reserves
- Once invoices started clearing, we didn't immediately hire more people
- We built a 2-3 month operating reserve
- This buffer meant we could hire team members before money arrived, instead of waiting
Decision 3: Stop Being the Default Decision-Maker
By July, I stopped asking "how can I work harder?" and started asking "what system can I design so this works without me bearing the full weight?"
When a developer got stuck, they asked me. When a client had a question, they asked me. When the team needed clarification, they asked me. This meant I was personally tied up with 50+ small decisions every day, which meant I wasn't actually working on business-level problems like "how do we manage cash?"
July By The Numbers
- Cash Position: We cleared all pending invoices and moved out of a negative position into a stable cash reserve, though cash flow is still catching up.
- Team Size: 12-14 people (developers, content team, QA)
- Projects In Pipeline: 40+ active concurrent deliverables
- Health: Still fragmented due to hospital visits, but improving as my mother's recovery progressed
- Key Hire: Brought on a dedicated Team Lead to oversee team performance and handle decisions I'd been making
PART 2: The Content Engine Crisis (And Why Silent Failures Are the Worst Kind)
By July, the content engine had become our biggest bottleneck. And the worst part? We didn't realize it was broken until clients started complaining.
What Went Wrong (In Specific, Not Vague Terms)
Failure 1: Incorrect Rich Text Formatting
Content was being generated with broken formatting. FAQ, Lists were showing up as single paragraphs. This destroyed readability and hurt SEO.
Failure 2: Lorem Ipsum Appearing on Live Sites
This was the one that kept me up at night. The content team was supposed to audit generated content before it went to developers. But with 1,500-1,800 pieces of content per project, they were rushing. Placeholder text from the content engine was ending up on staging websites.
Imagine being a customer looking at a business website and seeing "Lorem ipsum dolor sit amet consectetur..." That's not just unprofessional. It destroys credibility.
Failure 3: Fake AI Summaries
The LLM was hallucinating content. It would generate convincing-sounding text that had nothing to do with the actual service being described.
Failure 4: Broken Internal Linking
Pages weren't linking to related services. This created 404 errors and killed both user experience and SEO.
Why It Happened (The System Level, Not the Blame Level)
Here's what I want to be clear about: this wasn't about lazy or incompetent people. It was about a broken system.
The root cause was this:
- We had 5-6 people using the content engine simultaneously, each hitting the API
- We had no centralized dashboard showing which content was generated, when, or what quality
- Once content was generated, developers trusted it was correct and moved to auditing
- No one was spot-checking output systematically
- We were optimizing for speed (get content out fast) but had almost no quality gates
In other words: we designed the system for speed and forgot to design it for maximum quality.
The Rebuild: July and August
Phase 1: Isolation and Monitoring
In July, we made a critical decision that sounds redundant but was actually genius: duplicate the content engine so each team member had their own isolated instance.
Why? Let me explain what this actually meant:
- API rate limits would no longer bottleneck everyone. Before, if 6 people were using the engine simultaneously, they'd all hit rate limits. Now each person had their own quota. They could work in parallel instead of waiting in queue.
- Parallel work actually worked in parallel. Before, shared resources meant slow-downs and conflicts. Now each person had their own system.
- If someone's instance broke, it didn't take down the whole operation. If my system crashed, everyone else could still work. They could use someone else's system instead of waiting for me to fix the infrastructure.
- We could track which person was generating what quality of output. Accountability became clear. We could see whose content was causing QA issues.
This meant creating 5-6 separate n8n automations, each with their own Airtable workspace and API credits. It looked redundant on paper. In practice, it was exactly what we needed.
Phase 2: Pre-Flight Checklist (Before Content Goes to Developers)
We created a checklist that every generated piece of content had to pass before a developer even saw it:
- ☐ Rich text formatting is clean and readable
- ☐ No Lorem Ipsum or placeholder text
- ☐ No obviously fake or hallucinated sentences
- ☐ All internal links point to pages that actually exist
- ☐ Image references are populated (not empty)
- ☐ Meta description is written with fluid seo
- ☐ Company name is correct (not a previous client's name)
- ☐ Heading hierarchy makes sense (proper H1, H2 structure)
This wasn't bureaucracy for bureaucracy's sake. It was a gate that prevented garbage from flowing downstream. If content didn't pass this checklist, it went back to the content editor for revision. Simple. Clear. Non-negotiable.
Phase 3: 3-Hour Training Video
In late July, I sat down and recorded a raw, no-nonsense training video on the content engine. Three hours of video, broken into practical modules:
- What to do – Here's the step-by-step process, start to finish
- How to do it – Here's exactly how you execute each step, including keyboard shortcuts and common mistakes
- Why you're doing it – Here's why it matters (the client needs good SEO, customer trust requires professionalism, etc.)
The video wasn't polished or pretty. It was practical. By September, every new team member watched it, and the quality of content generation improved measurably. More importantly, people understood why they were doing the work, not just how.
%20(1).png)
The Critical Realization About Bottlenecks
At one point in August, I realized something: we were obsessed with developer velocity. How many projects can a developer ship per week? Can we get them to 2 per week instead of 1?
But developers couldn't move faster than content was approved. We had developers sitting idle waiting for content. The real bottleneck wasn't builds. It was content.
Once we fixed the content pipeline—isolated instances, pre-flight checklists, clear ownership—developers suddenly had a steady stream of work. Velocity went up. It wasn't because developers worked harder. It was because we removed the constraint.
What We Actually Built: Robust Process + Human Judgment
We could have tried to build a fancier AI system that required less human oversight. We could have spent more on better LLMs or more sophisticated prompt engineering.
Instead, we chose something less impressive but more reliable: robust process + human judgment beats fancy automation + no oversight.
This means our content generation is faster than hiring writers but slower than a fully automated system with no human checks. But it's predictable. It's reliable. It doesn't ship garbage.
In agency terms, that's worth more than raw speed.
September's Content Engine Crisis (The One We Didn't Expect)
Just when we thought we'd fixed the content engine, September revealed a new problem: templates with hardcoded company names.
Here's what happened: We built a template for a home services company. It had sections that said "Welcome to [Company Name]" Makes sense.
But when we reused the template for a new client, someone hardcoded the first client's name into the template. When we deployed it for the second client, it went live saying "Welcome to WSC" for a company called "We Shall Conquer"
This sounds like a one-off mistake. It wasn't. It happened across multiple projects because we were copying templates manually instead of using variables.
The fix was simple but critical: rebuild all templates to use dynamic variables instead of hardcoded values.
A template now says [COMPANY_NAME] instead of WSC. When we reuse it, we update the variable once, and it propagates everywhere. One change, 50 pages updated automatically.
This is a small change that prevented dozens of embarrassing launch mistakes. It's the kind of thing you don't notice until you stop doing it wrong.
PART 3: Building Micro-Teams (How We Stopped Being a Bottleneck)
The Problem With Centralized Leadership (Or: Why I Was Drowning)
By July, I had a realization that hit me like a truck: the agency couldn't function without me.
When I was in the hospital in June, project delays happened. Quality suffered. Team members didn't know who to ask for decisions. Clients got confused.
I'd try to handle things from the hospital cafe, sitting between checking on my mother. I'd open my laptop when there was a window of time, answer 50 Slack messages, try to make 5-10 decisions that were waiting on me, and then close it when a doctor called my name.
It was unsustainable. And it was entirely my fault.
The issue wasn't lazy people or incompetent developers. The issue was architecture: I had designed a hub-and-spoke model where I was the hub. Every decision, every question, every escalation flowed through me.
This is fine when you're a solo freelancer doing $5,000 projects. It's a catastrophe when you're managing 20+ concurrent projects, 12 team members, and an enterprise client.
The Micro-Team Structure: What It Actually Looks Like
Starting in July, we moved to a project squad model. Each project got assigned:
- 1 Lead Developer – Owns the technical delivery and quality. They make technical decisions. They own the code. If something breaks, they know why.
- 1 Content Editor – Owns all content generation, migration, and audit for that project. They understand the client's business. They review generated content. They're responsible for quality.
- QA Specialist (shared across 2-3 projects) – Verifies everything before client delivery. They're the last gate before something goes live.
- Clear Handoff Points – Content editor prepares content → Developer builds the site → QA validates → Client receives
This team of 3-4 people works as a single unit. They have:
- Shared Slack channel for just that project (so communication stays in one place, not scattered across 10 channels)
- Weekly sync on Monday to plan the week and align on priorities
- Daily reporting on Slack (asynchronous, not meetings that waste time)
- Clear definition of "done" – We all agree on what "complete" actually means before we start
Why Micro-Teams Actually Work (And Why It Surprised Me)
Before this structure:
- A developer would get stuck on something and ask me for a decision
- I'd respond 2 hours later, and the developer had been blocked
- Quality issues appeared on live sites because no one felt ownership of the final product
- It was "the developer's job" or "the content team's job," but nobody felt personal responsibility
After micro-teams:
- A developer gets stuck and asks their lead developer. Decision happens in 5 minutes.
- The team owns the project from start to finish. If there's a Lorem Ipsum mistake, it's visible to everyone immediately. They fix it because it's their project.
- Developers stay in context (working on the same project for weeks) instead of context-switching between 5 projects simultaneously
- Decisions happen at the project level, not at the founder level
This is a shift from functional silos (all developers in one group, all content editors in one group, all QA in one group) to project-based squads where multiple functions work together.
When you organize by function, communication is slow and responsibility is diffused. When you organize by project, communication is fast and responsibility is clear.
Operational Systems That Survived Reality
The SOP Revolution: Teaching the System, Not the Person
In August, we stopped trying to pass knowledge person-to-person (which is slow and error-prone) and started documenting it systematically.
What we documented:
1. Sitemap & Menu Creation Process
Before: We'd wait for clients to provide the sitemap. It would take weeks. Sometimes it was wrong. We'd waste development time rebuilding things.
After: We took ownership. We built the sitemap and menu structure ourselves based on the client's services. The client reviewed and approved, but we led the work. This removed a major blocking point and got projects moving faster.
2. Content Migration Workflow
Step-by-step documentation: export from Airtable, prepare CSV, import to Webflow, audit, add images, create internal links. Each step had clear expectations and quality gates.
3. Reference Field Setup in Webflow
This used to confuse new developers. How do you link a blog post to the service category it belongs to? How do you set up multi-reference fields? We documented the exact approach we'd validated, with screenshots and common mistakes to avoid.
4. Resume Upload Functionality
Instead of upgrading the Webflow account to a more expensive plan, we created a specific SOP for setting up file upload forms using custom code. We documented the exact approach we'd built and tested.
5. Quality Audit Checklist
Before projects go live, they have to pass 20+ checkpoints:
- All pages has meta data?
- No broken internal links (404s)
- No AI Summaries in the content
- Form submissions are actually sending data
- etc.
The outcome: New team members could watch a training video and execute complex processes without asking questions. We went from "ask someone" to "check the documentation."
This is how you scale beyond yourself. You document the knowledge. You make it repeatable. You don't need the person who originally figured it out to stay around.
PART 4: Create Clear Quality Gates Before Launch
Don't rely on final inspection to catch mistakes. Design the process to prevent mistakes:
- Pre-flight checklists before content goes to developers
- Automated checks for common issues (missing alt text, broken links, duplicate H1 tags)
- Clear definition of "done" before QA even starts
Prevention is cheaper than inspection.
Investment in Tools and Infrastructure (Because Good Hardware Matters)
The MacBook M4 Pro: Why Better Tools Actually Make You Faster
In August, I finally bought a MacBook M4 Pro with nano texture display and 1TB storage. It was actually a productivity investment.
What I was using before: An Acer Nitro gaming laptop from 4-5 years ago.
This laptop had:
- A loud fan that sounded like a helicopter taking off
- Performance that had degraded significantly over 5 years of use
- Crashes when opening large files
- A battery that barely lasted 30 minutes
Every time I needed to do serious development work—debugging a code issue, setting up a Webflow integration, reviewing developer code—it was a 15-minute ordeal. The laptop would lag. I'd get frustrated. I'd lose my train of thought.
Why it mattered: As a founder, I was still doing technical work. I wasn't just managing people.
Using a slow machine meant:
- I personally was slower (15-30 minutes on tasks that should take 5)
- I got frustrated (which affects decision-making quality)
By investing in better hardware, I actually increased my own velocity and reduced my frustration level.
I kept the Acer as a secondary screen for monitoring or reference, but the MacBook became my primary workstation. The difference was immediate. Tasks that used to take 20 minutes took 5.
Automation Subscriptions: Removing Hours of Stupid Work
In August, we invested in subscriptions for automation tools:
Fluid SEO – For automating metadata generation (meta titles, meta descriptions, alt text)

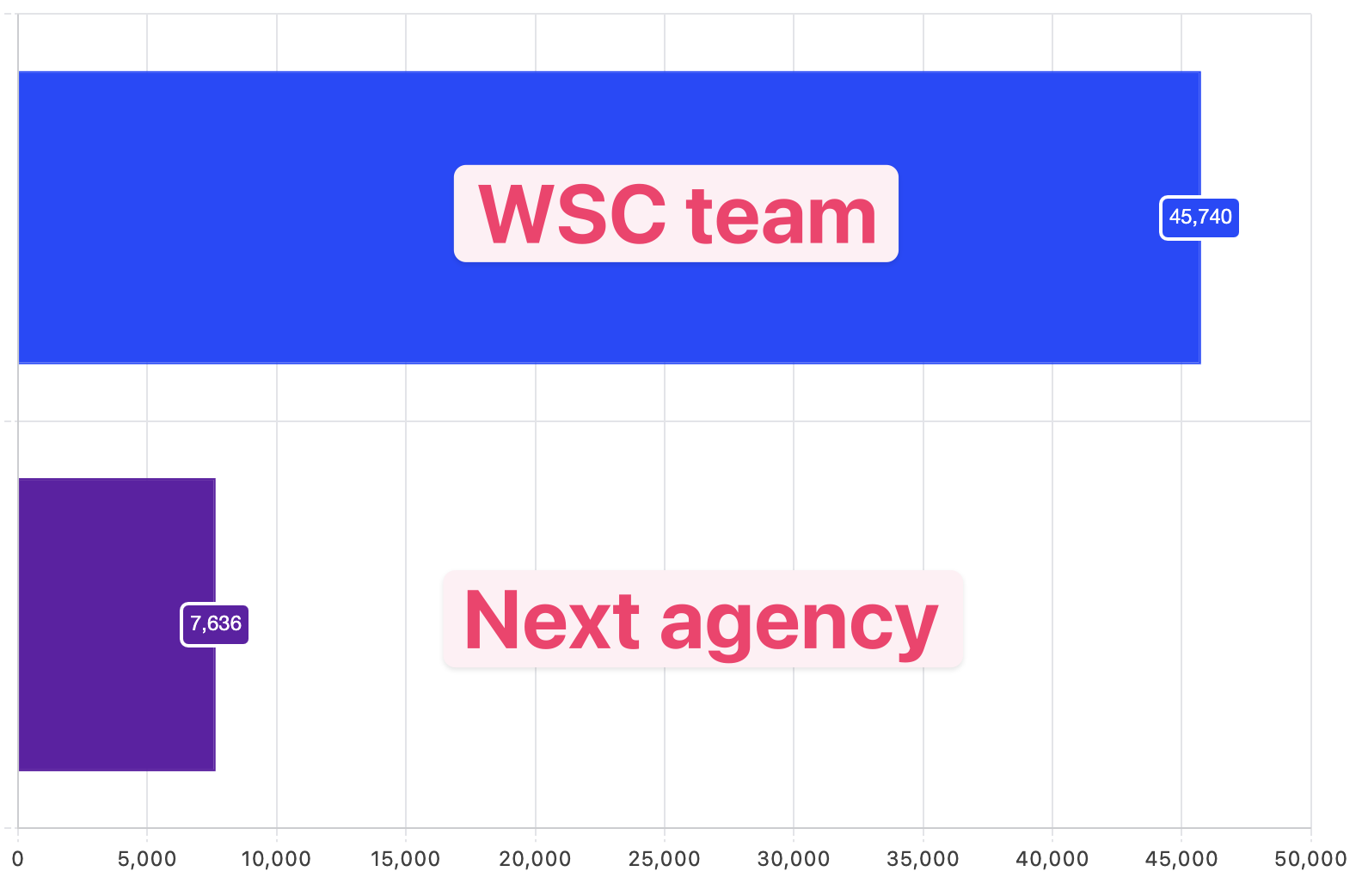

We were using this tool so heavily that in a single month, we became a top 1% user of the platform. The Fluid SEO team noticed and reached out to understand our use case. Instead of manually writing 50 meta titles for 50 pages, we could batch-process them. Instead of manually adding alt text to 100 images, we could do it in bulk.
Markdrop – We used Markup before, but after our data got archived by the Markup team, we migrated to Markdrop for visual feedback and QA.
These tools saved an estimated 1-2 hours per project. Across 25 projects, that's 25-50 hours per month of work that could be redirected to creative or strategic work instead of tedious manual tasks.
The lesson: Small investments in tool quality compound over time. If you're using your equipment 8 hours a day, spending an extra money to get something that works 3x better is a good investment.
None of these were luxury expenses. They were friction-reducing infrastructure.
The September Snapshot (Where We Actually Stood)
By September, the infrastructure had stabilized. Not perfectly. But it was functional.
Team Structure
- Lead Developers: Owning project delivery and quality (5-6 people)
- Content Team: Dedicated to content engine and migrations (3-4 people)
- QA: Validating before client delivery (2 people, shared across projects)
- Operations: Me, running strategy, client relationships, and infrastructure
Project Velocity
- Completed in September: 10-13 projects
- In Pipeline: 30+ projects at various stages
- Average timeline: 4-5 projects/weeks from template to first draft
Key Learnings and Principles That Actually Matter
The Core Principle: Systems Over Heroes
From July to September, we learned something that changed how I think about business: sustainable growth comes from systems, not heroes.
A hero can work 16-hour days and ship everything. But then:
- They burn out
- They become a bottleneck
- When they're gone (hospital, vacation, burnout), everything collapses
- They attract people who like firefighting instead of building
By moving to micro-teams, documenting SOPs, and creating clear quality gates, we made the business less dependent on any single person. It's slower than me doing everything myself. But it actually scales.
The uncomfortable truth is this: if your agency can't function without you for a week, you haven't built an agency. You've built a job for yourself.
The Second Core Principle: Speed With Quality Gates (Not Speed vs. Quality)
From the Ben AI project in April, I learned that shipped > perfect.
But from the content engine crisis in June-July, I learned that shipped low-quality is worse than slow-but-good.
The resolution: Ship quickly with quality gates.
Here's how it works:
- Generate content fast (90% complete)
- Use checklists to catch obvious mistakes
- Launch the project
- Iterate on refinement based on real user feedback
This beats both "ship garbage fast" (which destroys trust) and "perfect but never ships" (which misses market timing).
Lessons We Got Wrong (And Fixed)
Mistake 1: AI Content Can Be Semi-Automated
- Reality: It needs human judgment and spot-checking at every step
- Fix: Isolated instances + pre-flight checklists + dedicated content lead
Mistake 2: We Could Scale Without Clear Roles
- Reality: Ambiguous roles = constant escalations to the founder
- Fix: Micro-team structure with clear ownership per project
Mistake 3: Velocity Metrics Were Enough
- Reality: "Projects completed" hides all the important variables
- Fix: Track time-to-QA, quality issues, client satisfaction
Mistake 4: Documentation Was Overhead
- Reality: Documentation is how you scale beyond yourself
- Fix: Invested in training videos, SOPs, checklists
WHAT TO DO (Lessons That Worked)
1. Move to Micro-Teams Early
Don't wait until you have 10 developers. Once you have 3-4 concurrent projects, assign a small team to each project. Let them own delivery end-to-end. Decision-making happens at the project level, not at the founder level.
The difference in velocity is shocking. Projects move faster because decisions don't need to escalate to you.
2. Invest in Systems & Tools Before You Hire More People
A $65/month subscription that saves 20 hours of manual work is cheaper than hiring another person at $2,000/month. It also compounds—your existing team becomes more productive, not just busier.
Tool investments also don't require management. You buy it, you use it, you get the benefit.
3. Document Everything, But Make Documentation Practical
SOPs that are 50 pages long won't be read. Create 3-5 minute training videos instead. Show what to do, how to do it, and why it matters. Update them as you learn and evolve.
When documentation is easy to consume, people actually use it.
4. Create Clear Quality Gates Before Launch
Don't rely on final inspection to catch mistakes. Design the process to prevent mistakes:
- Pre-flight checklists before content goes to developers
- Automated checks for common issues (missing alt text, broken links, duplicate H1 tags)
- Clear definition of "done" before QA even starts
Prevention is cheaper than inspection.
5. Separate Pace of Work From Quality of Work
You can ship fast (90% complete) and still ensure quality (by using checklists and human judgment). These aren't opposites if you design them as separate stages.
The trick is recognizing that "done" doesn't mean "perfect." It means "functional and ready for the market."
6. Link Compensation to Client Outcomes
Performance-based pay (base salary + bonuses for quality) actually works. People perform better when they see the connection between their work and their earnings.
This isn't heartless. It's honest. You're saying: "I value what you produce. The better you produce, the more you earn."
WHAT NOT TO DO (Mistakes to Avoid)
1. Don't Scale Without Cash Reserves
Growing from 10 to 30 projects per month while getting paid 60 days later is a recipe for crisis. Build cash reserves before you scale headcount. Negotiate better payment terms. Don't let growth destroy your financial stability.
2. Don't Make Yourself the Single Point of Failure
If the business can't run for a week without you, you have a system problem. Build micro-teams and document decisions early.
This isn't delegation. It's survival.
3. Don't Automate Before You Have a Reliable Manual Process
We tried to automate content generation before we understood how content should be structured. It was a disaster. Manual first, then optimize the manual process, then automate.
Automating a bad process just makes it fail faster.
4. Don't Ignore Quality Signals
Lorem Ipsum on live sites isn't a small issue. It's a sign your whole process is broken. Fix it at the system level, not by hoping people remember to check.
When quality issues appear, trace them back to the system that allowed them. Don't blame people. Redesign the system.
5. Don't Measure Activity Instead of Impact
"Projects completed" sounds good, but it hides the real variables (how much was already done, how much was quality, how much manual work was involved).
Measure time-to-delivery, quality issues, and client satisfaction instead. Measure the things that actually matter.
6. Don't Hire Fast, Fire Slow
By September, it was clear some people weren't right for the role. Making that decision earlier would have been better than spending months in "probably they'll improve" mode.
Misalignment is painful for everyone. Address it quickly.
7. Don't Optimize for Hours Worked
The 14-16 hour days in April-June didn't produce better results. They produced burnout. Systems that run on less effort are better systems.
Founder hours don't scale. Systems do.
Our 2025 was chaotic, painful, and real. The systems we built in July–September came from hitting walls and choosing to fix the walls, not pretend they weren't there.
That's the kind of agency we want to be: transparent about constraints, relentless about systems, and committed to building infrastructure that scales without breaking people.
